EasyFinance.com Blog

How Do Construction Loans Work When You’re Starting From a Blank Slate?

Posted June 1, 2026 by EasyFinance.com to Banking 0 0













Buying an established house is a straightforward transaction. The bank hands over the money on settlement day, you get the keys, and the mortgage begins. Starting with a blank piece of dirt operates on a completely different set of rules.

A construction loan is a heavily controlled financial product. The lender holds onto the funds and only releases them in stages as the physical structure takes shape. They do this to mitigate risk. If the builder goes into liquidation halfway through the project, the bank wants to ensure they have only paid for the work actually completed on site.

They will not hand you a massive lump sum to manage yourself. You have to work within their operational framework from the day you secure the block to the day of handover.

The Mechanics of Progressive Drawdowns

Construction loans operate on a strict schedule of drawdowns. The bank pays your builder directly at specific milestones.

These stages are standardised across the Australian building industry:

  • Deposit: Paid to get the working drawings and council permits sorted.
  • Base or Slab stage: Released after the site is prepped and concrete is poured.
  • Frame stage: Paid when the structural frame is erected and approved.
  • Lock-up stage: Triggered when the roof, external walls, and windows are secured.
  • Fixing stage: Covers internal cladding, plasterboard, and cabinetry.
  • Practical completion: The final payment made at handover.

At each milestone, the builder sends you an invoice. You sign an authorisation form confirming the work is done and forward it to the lender. The bank then releases that exact amount to the builder. Sometimes the lender will send their own valuer out to the site just to verify the frame is actually standing before they transfer the funds.

It is a rigid process designed to protect the bank's security and keep the builder accountable for their timeline.

Securing the Dirt Before the Build

You usually need two separate lending phases when you start from nothing. You have to buy the land first.

If you buy a vacant block in a new residential estate, the land might not be registered yet. You sign the contract, but you cannot settle until the developer finishes the roads, installs the services, and the titles are issued by the state government. Once the land titles, you take out a standard loan to settle the block. You will also pay stamp duty on the land value at this point.

You might sit on that vacant land for months while finalising your architectural drawings, engineering reports, and council approvals. You pay a standard mortgage on the dirt during this period. Once your builder is ready to mobilise on site, the bank restructures the facility to include the construction loan for the actual house.

Dealing with Existing Structures

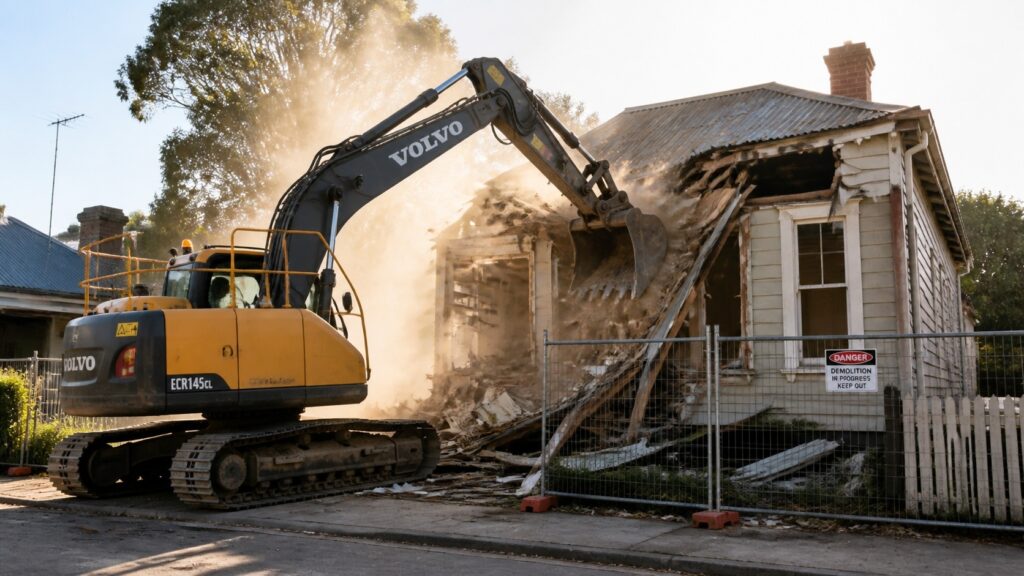

Not every site starts out empty. A very common approach is buying an older property on a decent block of land with the intention of tearing it down to start fresh.

Taking on a knockdown rebuild Brisbane project changes how the bank views your collateral. If you tell your lender you plan to demolish the house immediately, they will value the asset purely on the land. The existing structure adds zero value. It is actually considered a liability because clearing the site costs money.

You need to manage the timing carefully. You have to fund the initial purchase, get the demolition approved by the local council, clear the site, and have your new building contracts ready. If the lender is aware of the planned demolition, they will not lend against the purchase price of the old house. They will only lend against the land value and the proposed new build.

Buyers often get caught out here, expecting standard home loan borrowing capacity on a house they intend to destroy within weeks of settlement.

Valuations on Something That Doesn't Exist Yet

Lending against a finished house is easy because the valuer can walk through the front door and look at the fixtures. Lending against a blank slate requires an "as if complete" valuation.

The bank relies on their valuer to read your building contract, look at the architectural plans, and determine what the property will be worth the day the builder hands over the keys. They compare your proposed house to similar newly built homes selling in the same suburb.

This valuation step is where many projects hit a wall. If your build costs are exceptionally high due to premium custom finishes or difficult site conditions requiring massive retaining walls, the final valuation might come in lower than the combined cost of your land and the build. Because the bank only lends against their valuer's figure, you must cover any shortfall with your own cash before the first construction payment is released.

The rules become even stricter if you decide to build a duplex or a set of townhouses on that block. At that point, you start moving into property development finance, which requires different deposit sizes, presale commitments, and commercial risk assessments. Residential lenders want to see a single home for a single family.

The Fixed Price Contract Requirement

Banks need absolute certainty about the final cost of the build. They require a fixed price contract from a licensed builder before they approve the loan.

Lenders generally refuse to fund owner-builder projects or cost-plus contracts where the final price is open-ended. They want the risk of cost blowouts absorbed by the builder, not the borrower. They will also demand proof of the builder's Home Warranty Insurance before authorising the first drawdown.

You still need to review the fine print for provisional sums and prime cost items. These are allowances for site works, driveway concrete, or specific fittings where the builder has only estimated the cost. If your contract is full of heavy provisional sums, the bank views it as a risk. They might demand you hold extra cash in reserve just in case the earthworks hit solid rock and the site costs double.

Variations are another major issue. If you decide halfway through the build that you want better tiles or a larger kitchen island, the bank will not increase your loan limit to cover it. Any variations you sign off on after the loan is approved must be paid for directly out of your own pocket.

Keeping Your Cash Flow Intact During the Build

Managing cash flow is a major concern when you are paying rent elsewhere while waiting for your house to be finished.

Construction loans default to interest-only repayments during the build phase. You are only charged interest on the funds the bank has actually transferred to the builder.

When the slab is poured and the first invoice is paid, your monthly repayment is just the interest on that small initial amount. As the walls go up and more funds are released, your monthly interest bill increases. It only reaches the maximum amount right at the end of the project.

Once practical completion is achieved and the final payment is made, the loan converts. The interest-only period ends, the loan switches to principal and interest, and your full regular repayments commence. It is a highly practical system designed to keep holding costs manageable while the site is just a construction zone.
